Mark Moore


Trackers

Regular readings of the published connection registers, newest first. The TEC Register tracker compares NESO’s weekly Transmission Entry Capacity files; the Embedded Capacity Register tracker is monthly and covers the six distribution network operators. Figures are as published at the time. Where a later edition corrects an earlier one, the correction is in the later edition.

UK data centre map

Data centre schemes in development across the UK, each qualified from primary sources and rated by how it plans to be powered, with a watch list of schemes not yet clearing every test. Edition 2 was published on 10 November 2026. The map is a free resource and is on its own page: UK data centre map.

TEC Register

The running account across editions, with the register level, departures and arrivals, Gate 2 labels, project status and connection years, is on the TEC Register summary page.

NESO register tracker, edition 11: 3 to 10 November 2026

Posted 11 November 2026 · View on LinkedIn · See the running summary

Equinor Celtic Sea 2 (1,000 MW) is back on Gate 1. It carried the label on 21 September, lost it on 28 September with nothing else on the row changing, and has sat on the register without a gate in every weekly file since. In edition 5 I called that currently unexplained. On 10 November the label returned, against the same December 2036 date. The register gives no reason for either change. Read the full post

Gate 2 this week was entirely Scottish. Seven projects reached it (1.2 GW), none of them up from Gate 1: six in the north of Scotland and Sanquhar II Wind Farm (250 MW) in the south. The largest is Loch na Cathrach Pumped Storage Hydro (550 MW), which also moved its connection to a new switching station. Three of the seven came in smaller than they were: Garvary Wind Farm from 222 to 144 MW, Tomchrasky Wind Farm from 74.4 to 63 MW and Beinn Ghlas from 57.6 to 35 MW.

Every connection date that moved this week, nine rows in all, belonged to one of those seven. With gate changes set aside, net date movement was zero on both methods.

The rest was quiet. The level rose 588 MW to 688.6 GW. Pelham Farm 2 (700 MW) joined with a Gate 1 label and an October 2032 date, and nothing left. Seventeen projects picked up Gate 1 (4.5 GW), and Gate 2 now covers 145 projects and 26.5 GW.

If a gate label can be off for six weeks and come back without explanation, what should anyone read into a project that doesn’t carry one?

Independent work, no client and no commercial interest in what the figures show. Whatever they show gets published.

The running summary of every edition, with the register level, joiners, leavers and Gate 2 labels since August, is at markdmoore.co.uk/monitor

Source: NESO Transmission Entry Capacity Register, files of 3 and 10 November 2026.

NESO register tracker, Edition 11, TEC Register, 3 to 10 November 2026: 2,083 projects, 688.6 GW capacity, net +588 MW this edition.

NESO register tracker, edition 10: 27 October to 3 November 2026

Posted 4 November 2026 · View on LinkedIn · See the running summary

The TEC Register fell 2,728 MW this week to 688.0 GW. Leaving aside the 3.6 GW that moved to the Interconnector Register in September, that’s the biggest weekly fall since I started tracking in August, and two thirds of the real movement came off projects that are still on the register. Read the full post

East Claydon Green Energy Centre held two 1,025 MW tranches, one dated October 2034 and one October 2038. The 2038 tranche has gone, so the project now sits on a single 1,025 MW row, registered to East Claydon Green NG Limited. Harker Green Energy Centre went the same way, from 1,025 MW across two tranches down to its 400 MW first tranche, losing 625 MW dated 2032. Cowley Energy Storage dropped a 100 MW tranche dated 2036 and Mossy Hill Wind Farm was trimmed from 48 to 40 MW. Together that’s 1,758 MW.

Keadby, a built 910 MW gas station, has left the file, and the register gives no reason. Grimsby, a built 40 MW gas plant, appeared. The last 100 MW is NESO correcting Bearsden BESS, which had carried 100 MW twice since 13 October, so my two ways of adding up the register now agree to within 20 kW.

Dates hardly moved, +4.1 GW-months on both methods. Nearly all of that is East Anglia Three folding a 120 MW tranche dated December 2028 into its January 2026 row, a date that has already passed. Four projects reached Gate 2 (411 MW), none of them up from Gate 1, which takes Gate 2 to 138 projects and 25.3 GW. Seven picked up Gate 1 (1.8 GW).

If a project can drop its later tranches and keep its place, how much of the 688 GW is capacity someone still means to build?

Independent work, no client and no commercial interest in what the figures show. Whatever they show gets published.

The running summary of every edition, with the register level, joiners, leavers and Gate 2 labels since August, is at markdmoore.co.uk/monitor

Source: NESO Transmission Entry Capacity Register, files of 27 October and 3 November 2026.

NESO register tracker, Edition 10, TEC Register, 27 October to 3 November 2026: 2,082 projects, 688.0 GW capacity, net −2,728 MW this edition.

NESO register tracker, edition 9: 20 to 27 October 2026

Posted 28 October 2026 · See the running summary

Last week I named Rugby High Impact Green Energy Hub 1 (1,000 MW) as the project that came in four years, to October 2033. On this week’s file it is back at October 2037, the date it carried on 13 October. Read the full post

Rugby was one of many. Setting gate changes aside, fourteen rows changed connection month this week. Thirteen of them now show a month the same row had already held on an earlier file this month. FCC Thurcroft BESS (750 MW), GF Norwich BESS and EPL Suffolk are back on their 13 October dates. Noventum Long Stratton (460 MW) and Astwood Solar Farm are back on their 5 October dates. Petroc Offshore Wind Farm, which on 16 and 20 October showed a connection date already in the past, reads March 2029 again.

Net, dates moved out by 66.2 GW-months on both methods. The returning rows account for minus 92.3 of that. Only one row moved to a date not seen this month: Weaver BESS (240 MW), in from 2037 to October 2028.

Norfolk Vanguard East (1,320 MW) is back on Gate 2 with a Necton connection, as it was on 16 October, and is now marked Consents Approved.

The level slipped 37 MW to 690.7 GW. Nothing joined, and West Weybridge (Tertiary), 57 MW, left. Forty-one projects picked up Gate 1 (11.4 GW) and six reached Gate 2 (2.8 GW), none up from Gate 1, taking Gate 2 to 134 projects and 24.9 GW. Welbar Energy Storage’s first tranche, 349.9 MW, is now shown as built.

If a connection date can go out, come in and go back again across four files in a month, which file should anyone plan from?

Independent work, no client and no commercial interest in what the figures show. Whatever they show gets published.

The running summary of every edition, with the register level, joiners, leavers and Gate 2 labels since August, is at markdmoore.co.uk/monitor

Source: NESO Transmission Entry Capacity Register, files of 20 and 27 October 2026.

NESO register tracker, Edition 9, TEC Register, 20 to 27 October 2026: 2,082 projects, 690.7 GW capacity, net −37 MW this edition.

NESO register tracker, edition 8: 13 to 20 October 2026

Posted 21 October 2026 · View on LinkedIn · See the running summary

Last week’s lead was a data problem. NESO had Immingham’s 1,268 MW on the TEC Register twice, once as an increase on one row and again as connected capacity on the next. By 16 October the double count was gone, three days after it appeared. Read the full post

That correction is most of this week’s movement. On the published basis the level fell 492 MW to 690.8 GW. Take the double count out and real capacity rose 776 MW. One project joined, Elmya Ryston BESS & PV, 850 MW, arriving with a Gate 1 label and a 2034 date. Nothing left.

The 16 October file also gave Norfolk Vanguard East (1,320 MW) a Gate 2 label, a new connection site at Necton and an earlier date. By 20 October all three were back as they stood on 13 October. Compare the two weekly files and it never happened.

Gate movement was heavy. Nineteen projects reached Gate 2 (4.8 GW), none of them up from Gate 1, and seventeen picked up Gate 1. Gate 2 now covers 128 projects and 21.7 GW, from 109 and 16.9 GW.

Dates moved out, minus 74.9 GW-months (74.2 by project), and one project carries it. Bute Hydrogen Project 7.1 (2,400 MW) went from 2031 to 2038, minus 201.6 on its own. Everything else together came in by about 127, led by Rugby High Impact Green Energy Hub 1 (1,000 MW), four years earlier.

If a field can change and change back inside a week, how many snapshots before a movement on the register can be relied on?

Independent work, no client and no commercial interest in what the figures show. Whatever they show gets published.

The running summary of every edition, with the register level, joiners, leavers and Gate 2 labels since August, is at markdmoore.co.uk/monitor

Source: NESO Transmission Entry Capacity Register, files of 13 and 20 October 2026.

NESO register tracker, Edition 8, TEC Register, 13 to 20 October 2026: 2,083 projects, 690.8 GW capacity, net −0.5 GW this edition.

The TEC Register’s total moved 1.4 GW this week, and no capacity moved at all

Posted 14 October 2026 · View on LinkedIn · See the running summary

NESO published a TEC Register file on 13 October, eight days after the 5 October one. I run two totals over every file: the sum of every row, which is the basis I publish, and a control built from the register’s own project totals. For eight weeks they agreed to within 0.1 GW. This week they sit 1.368 GW apart. Read the full post

No capacity moved to cause it. Immingham holds 1,318 MW on both files. What changed is how NESO wrote it down. On 5 October it sat under one project number across two rows, with 1,268 MW recorded as connected capacity. On 13 October it has been re-keyed to PRO-000053-1 and PRO-000053-2 with stages populated, and that same 1,268 MW now appears both as an increase on the stage 1 row and as connected capacity on the stage 2 row. Add the rows up and you count it twice. Bearsden BESS, which joined this week, arrives written the same way and adds another 100 MW.

So the total is basis-dependent, and the basis can shift underneath you between publications with no notice. I put that risk in a study design in September, that any figure quoted from this register without a stated deduplication basis is unreliable. This is the first week I can put a date and two project numbers against it.

The rest of the week, on the basis I publish. The level rose from 679.0 GW to 691.3 GW, up 12.3 GW. Twenty-nine projects joined, one left, Hinkley Point B at zero MW. Twenty-five of the arrivals already carried a Gate 1 label and twenty-three more projects gained one, so Gate 1 stock rose by 48 projects and 18.9 GW in eight days. Connection dates moved 152.3 GW-months later on both measures, although Bute Hydrogen Project 7.1 pulls 2,400 MW forward by seven years on its own while its six siblings moved by a single day.

I am keeping the published basis for now. If the gap persists I will move to project totals and say so. The embedded register has not been republished since 5 October.

If you quote a queue total, which basis is it on, and would you know if it had changed?

Independent work, no client and no commercial interest in what the figures show. Whatever they show gets published.

A full history of all trackers is kept on my website markdmoore.co.uk.

Source: NESO Transmission Entry Capacity Register, files published 5 October 2026 and 13 October 2026.

NESO register tracker, Edition 7, TEC Register, 5 to 13 October 2026: 2,082 projects, 691.3 GW capacity, net +12.3 GW this edition.

NESO register tracker, edition 6: 28 September to 5 October 2026

Posted 7 October 2026 · See the running summary

Two projects left the TEC Register and none joined. The level fell 440 MW to 679.0 GW. Read the full post

Both exits were batteries with 2037 connection dates: Gastard BESS (200 MW, Melksham B) and Lambeeth 240MW (Pembroke). Both picked up a Gate 1 label in the file of 24 September. Eleven days later neither is on the register, and the register gives no reason. In twelve files since mid-August, this is the first time I’ve seen a project gain a gate label and then leave.

Dates went the other way from last week. Leaving aside gate changes, four projects moved, all later. Fleet (Tertiary) went out 33 months to July 2029, Cellarhead 400kV Energy Storage and Warley by 14 months each, and the first 400 MW tranche of Cilfynydd Green Energy Centre by 12 months to October 2029. Net, minus 11.4 GW-months on both the row and project methods.

Strathy Wood Wind Farm (63.5 MW) shows why the project method is there. Its two September 2026 tranches were merged into one row dated December 2029, with a Gate 2 label. Row by row, nothing changed date. The gate change keeps it out of the net.

Gate movement was heavier. Eight projects gained Gate 2, 1,366 MW on the labelled rows, including Thurrock’s 450 MW second tranche. Four gained Gate 1, 1,200 MW, of which 800 MW is Legacy Green Energy Centre’s second tranche.

If a project can gain a Gate 1 label and leave the register inside a fortnight, what is the label telling anyone about the capacity behind it?

Independent work, no client and no commercial interest in what the figures show. Whatever they show gets published.

Source: NESO Transmission Entry Capacity Register, files of 28 September and 5 October 2026.

NESO register tracker, Edition 6, TEC Register, 28 September to 5 October 2026: 2,054 projects, 679.0 GW capacity, net −440 MW this edition.

NESO register tracker, edition 5: 21 to 28 September 2026

Posted 30 September 2026 · See the running summary

Seven days between files, and the TEC Register barely moved. Two projects joined, one left, net minus 10 MW. Read the full post

Both arrivals are batteries that are already built, Care Wolverhampton BEGA (49.9 MW at Penn GSP) and Care North Tawton BEGA (30 MW at Alverdiscott GSP). The single exit was Melksham Grid Park ESS & PV, 90 MW with a 2037 connection date.

Connection dates are the interesting part. Devol Moor Battery & Solar (400 MW) came forward 25 months to September 2027, and Bryn Tilti (106 MW) came forward 17 months to February 2027. Willington Energy Park (500 MW) went out seven months to October 2028. Taken together that’s +8.3 GW-months, the first week of this series in which dates moved earlier overall. Row and project methods agree, as all three are single-tranche.

On gates, seven projects picked up a Gate 1 label (708.9 MW) and Benthead Solar (63 MW) picked up Gate 2. One label went the other way: Equinor Celtic Sea 2 (1,000 MW) lost its Gate 1 label with nothing else on the row changing. That is currently unexplained.

A method change. From this edition the register level is the sum of every row on NESO’s file, 679.4 GW today. On that basis the levels shown in earlier editions were 3.4 to 4.4 GW low. The weekly movements do not change.

If a gate label can come off the register without a reason attached, how much weight can anyone put on the gate column when sizing the reformed queue?

Independent work, no client and no commercial interest in what the figures show. Whatever they show gets published.

Source: NESO Transmission Entry Capacity Register, files of 21 and 28 September 2026.

NESO register tracker, Edition 5, TEC Register, 21 to 28 September 2026: 2,056 projects, 679.4 GW capacity, net −10 MW this edition.

NESO TEC Register tracker: Edition 4

Posted 23 September 2026 · files of 15 and 21 September 2026 · See the running summary

NESO published this week’s register on Monday, so this edition compares the 15 and 21 September files, six days rather than seven. Read the full post

First, a correction to last week. Tom Palmer pointed out that the two Xlinks agreements at Alverdiscott had moved to NESO’s interconnector register. They have: both are on the 21 September interconnector file at 1,800 MW each. So Edition 3’s 3.6 GW was a transfer between registers rather than capacity leaving the queue, and that week’s net movement was about plus 0.1 GW. From now on, any interconnector that leaves the TEC Register gets checked against the interconnector register before I count it as gone.

This week one agreement left and nothing joined. Celtic 2 Offshore Wind Farm, registered to RWE Offshore Wind at 1,000 MW with a Gate 1 label and an October 2031 date, isn’t on the 21 September file. Its 400 MW sibling, Celtic Offshore Wind Farm, is still there. Net movement is minus 1.0 GW, leaving 676.0 GW.

Fifteen agreements had a Gate recorded on countersignature, against five last week: seven at Gate 2 carrying 1,351 MW and eight at Gate 1 carrying 2,711 MW. Braintree, at 1,000 MW, was the largest.

Three dates moved by a month or more without a gate change. Two Wymondley agreements, 50 MW and 57 MW, went from October 2025 to May 2027. Drum Farm, a 49.9 MW battery, came forward two years to October 2026.

One move the row-by-row count misses. Willington Green Energy Centre shifted 625 MW of its 1,025 MW from a 2028 tranche to a 2031 tranche without the date on any row changing. From next week I’ll report date movement per project as well as per row.

The Embedded Register, which covers Scotland, held 544 projects and 12.9 GW on 21 September, 38 of them at Gate 2. I don’t have last week’s embedded file, so there’s no weekly comparison this time.

When a connection date moves earlier, as Drum Farm’s did, what would you want to know before believing it?

Independent work, no client, no commercial interest in what the figures show. Source: NESO TEC, Interconnector and Embedded Registers, files of 15 and 21 September 2026.

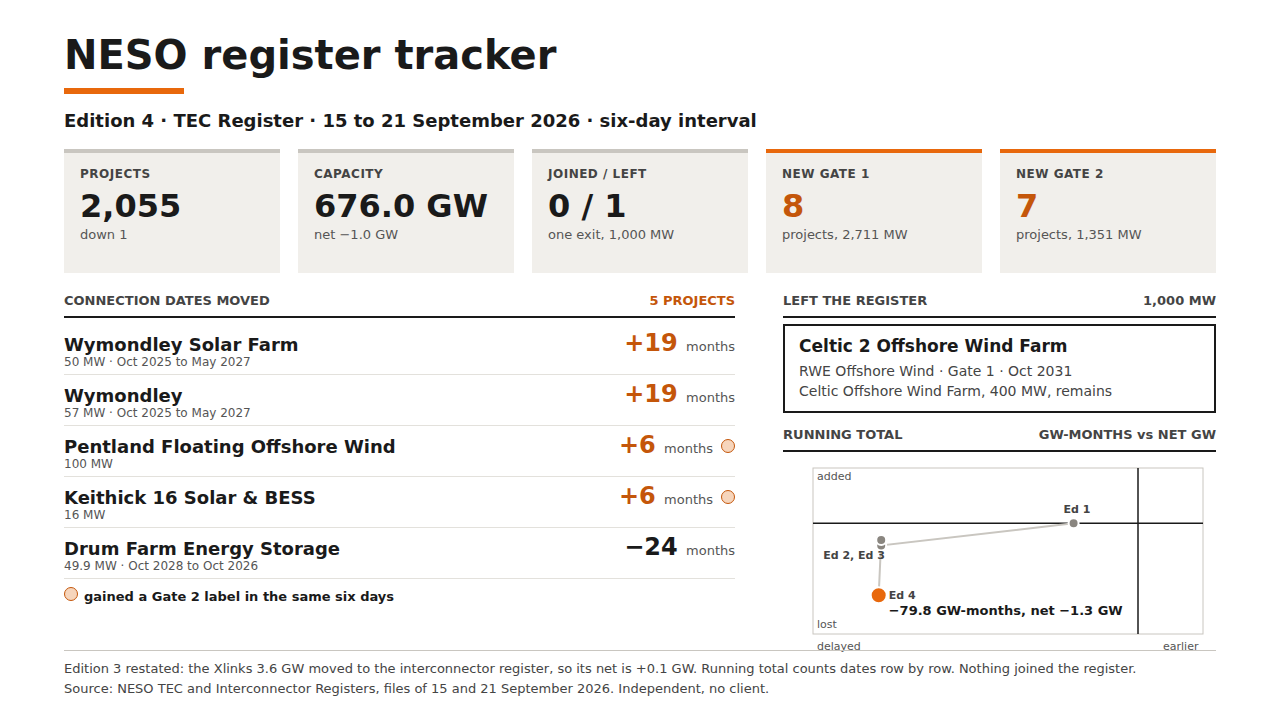

NESO register tracker, Edition 4, TEC Register, 15 to 21 September 2026: 2,055 projects, 676.0 GW capacity, net -1.0 GW; one exit, Celtic 2 Offshore Wind Farm, 1,000 MW; 8 new Gate 1 and 7 new Gate 2 labels.

NESO TEC Register tracker: Edition 3

Posted 16 September 2026 · files of 8 and 15 September 2026 · View on LinkedIn · See the running summary

Two connection agreements at Alverdiscott in North Devon came off the TEC Register between the 8 September and 15 September files. Both were held by Xlinks 1 Ltd, both were 1,800 MW interconnectors, and together they were 3.6 GW. Capacity on the register fell from 679.5 GW to 676.0 GW. Read the full post

I can’t tell you what that means, and neither can the register.

NESO’s own note explains why. A temporary data change governance process is running to protect queue integrity while Connections Reform works through, and NESO says some data corrections are taking longer than usual. So a removal might be a termination, a queue management action, or a correction finally landing. From outside, those three look identical.

I had a demonstration of that this week. On the 8 September file, a 212 MW onshore wind farm in Ayrshire appeared split into two rows, one of them labelled as offshore wind. On the 15 September file the split had been reversed and the label corrected. Seven days, no project event, and if I’d diffed 1 September straight to 15 September I’d have seen nothing at all.

The rest of the week was quiet. Two embedded storage sites joined at 49.9 MW each, both already built, so that’s existing capacity becoming visible rather than anything new. Five agreements had a Gate recorded on countersignature, four of them on SP Transmission. Not one connection date moved, which hasn’t happened before in this series.

I’m asking NESO’s open data team whether the Alverdiscott removal was a data correction. I’ll publish what comes back, including a refusal.

If you were underwriting a site on the strength of a connection agreement, what would you need this register to tell you that it currently doesn’t?

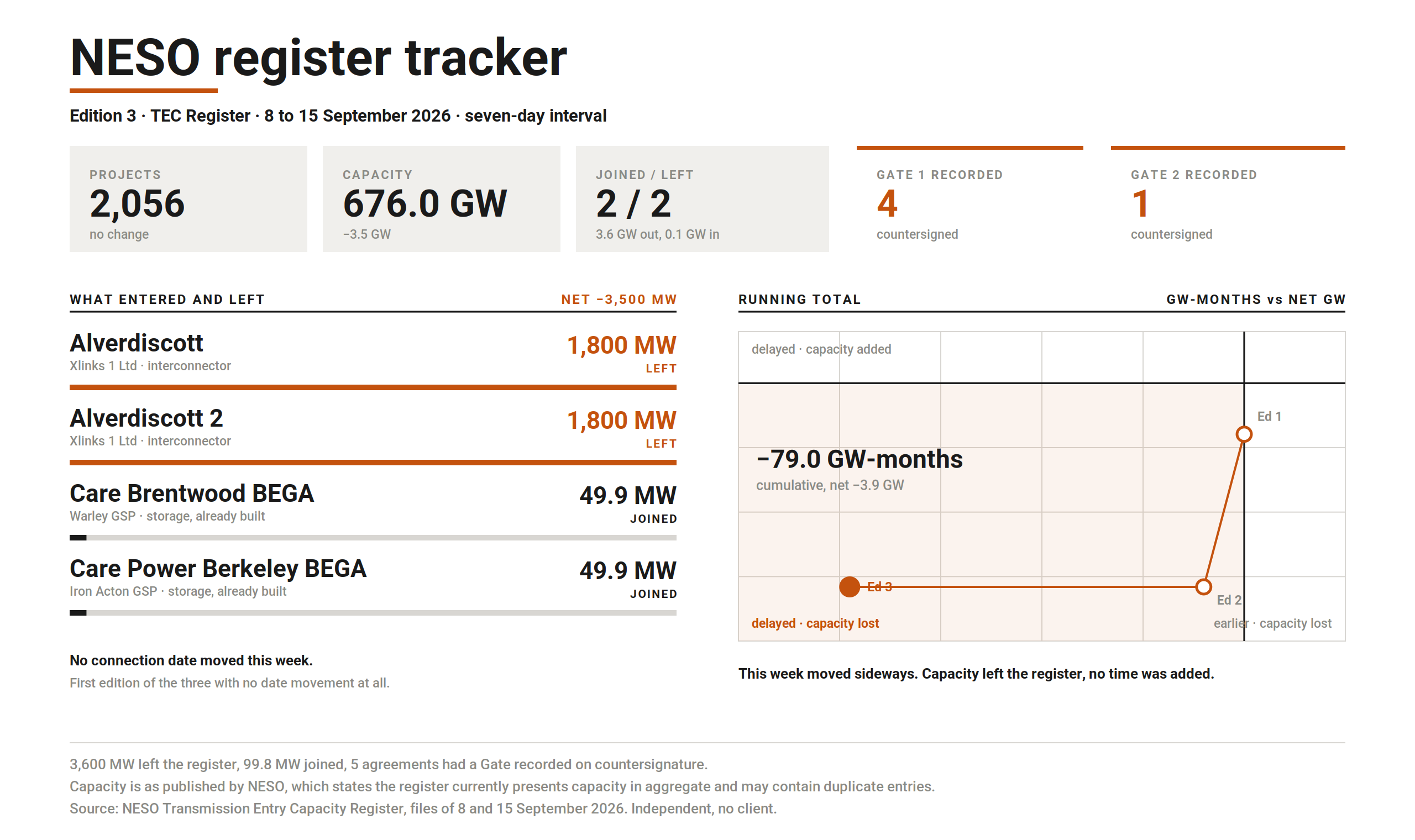

Graphic accompanying the post: NESO TEC Register tracker: Edition 3

NESO TEC Register tracker: Edition 2

Posted 9 September 2026 · seven days to 8 September 2026 · View on LinkedIn · See the running summary

Quiet week on the register itself. One project left, nothing joined, contracted capacity down 0.4 GW to 679.5 GW across 2,056 projects. Read the full post

The movement was in the dates. Five connection dates changed in the seven days to 8 September, every one of them outward, 1,599 MW between them and 133 months in simple sum.

Rampion Extension carries most of that. It sat at 1 August 2026 until this week, a date that had already come and gone by the time I pulled the previous snapshot, and it now reads 31 December 2029. That is 1,200 MW moving 41 months in a single update.

Four projects gained a Gate label, two at Gate 1 and two at Gate 2. None of them were the ones whose dates moved.

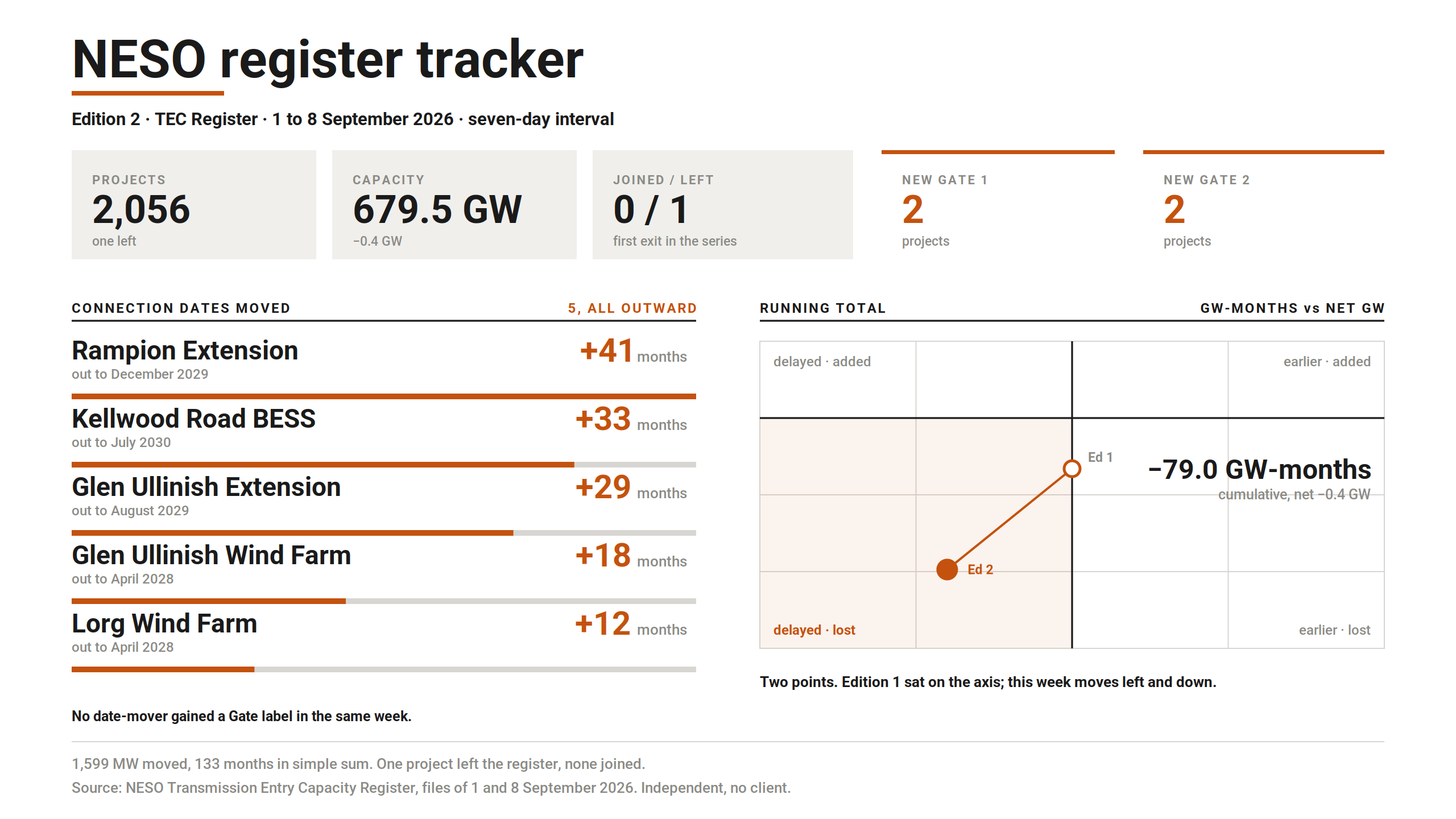

Graphic accompanying the post: NESO TEC Register tracker: Edition 2

NESO TEC Register tracker: Edition 1

Posted 2 September 2026 · 25 August to 1 September 2026 · View on LinkedIn · See the running summary

The connection registers move every week and almost nobody watches them. I'm going to publish what they do, whatever they show. Read the full post

Edition 1 covers 25 August to 1 September 2026. Seven days. Figures in the graphic.

The bit I didn't expect is the overlap. Five connection dates moved and every one of them moved outward. Four of the five gained a Gate 2 offer carrying a later connection date than the register previously showed. The Gate column populates on countersignature, so what you're seeing is an indicative date being replaced by a contracted one. The contracted date is later.

One week is not a pattern and 1,097 MW is not a lot. But if that's what countersignature looks like, a Gate 2 entry is worth reading differently.

No client, no commercial interest in what the figures show, and whatever they show gets published. Weekly, because the register moves faster than commentary on it does.

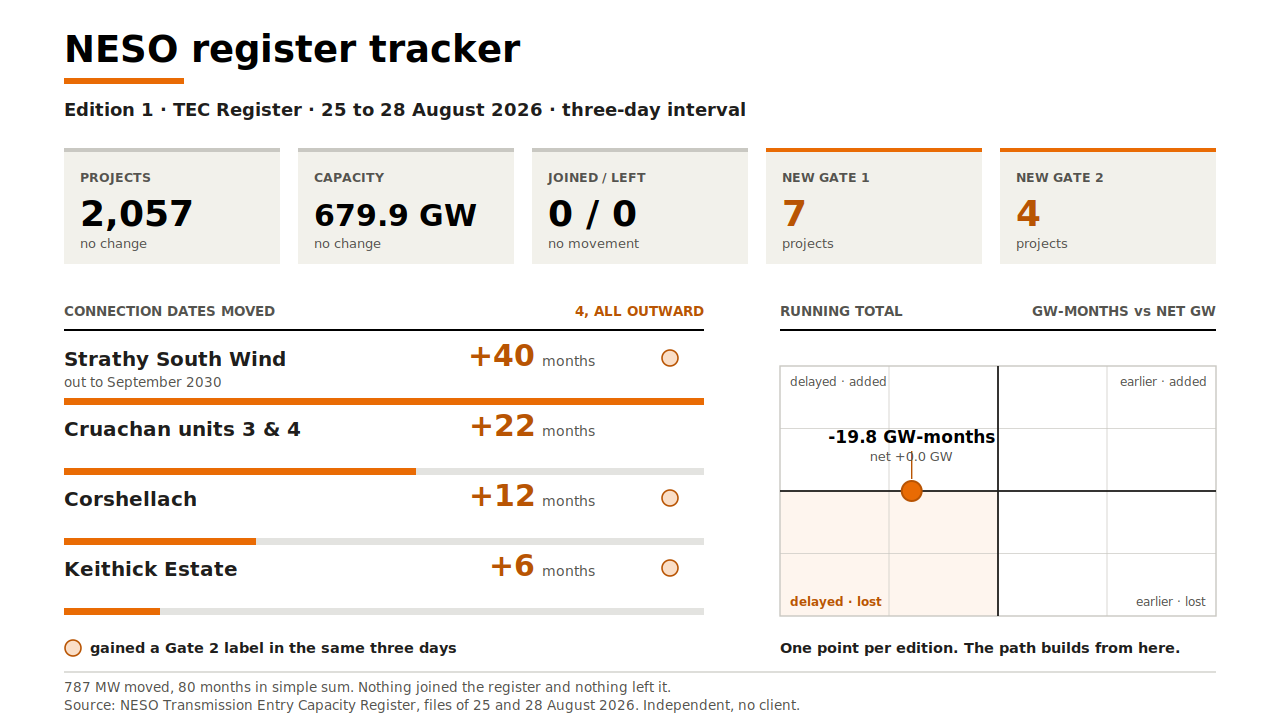

NESO register tracker, Edition 1, TEC Register, 25 August to 1 September 2026.

Embedded Capacity Register

Embedded Capacity Register tracker: Edition 2

Posted 27 October 2026

For regular followers this isn’t the TEC Tracker a day early, it’s Edition 2 of the long promised Embedded Capacity Register (ECR) tracker. Read the full post

Around 112.6 GW is accepted to connect to Britain’s distribution networks and not yet energised, across 2,764 schemes at 1 MW and above. September’s baseline was 114.5 GW and 2,782 schemes, so that’s a net fall of 1.9 GW and 18 schemes.

That figure comes with a caveat. Only four of the six operators published a newer register this month. NGED’s file is still its August edition, and SP Electricity North West’s (SP ENW) download on 22 October was identical to September’s. Both are carried forward unchanged. Between them they hold 40.2 GW, about 36% of the national total.

All of the movement therefore comes from the four that did refresh:
Northern Powergrid, down 1,437 MW, four fewer schemes net
SSEN, down 424 MW, seven fewer net
SP Energy Networks, down 109 MW, eight fewer net
UK Power Networks, up 89 MW, one more net

These are net figures. The registers share no common scheme reference, so I can’t yet tell whether a scheme that dropped off was connected or withdrawn.

Two of the refreshed files also changed shape. SP Energy Networks has cleared the duplicate pairs I flagged in Edition 1: the file has gone from 1,501 rows to 774, each identifier listed once, and the total lands close to the lower reading I used last month. Northern Powergrid now publishes a target energisation date on every live scheme, where in September it published none.

Edition 3 follows in November. If NGED and SP ENW have refreshed by then, it will be the first month in which all six move together.

Provenance: Original analysis. Computed from the six DNO groups’ own published Embedded Capacity Registers. Collected 16 October 2026 and rechecked 22 and 25 October. NGED (August 2026 edition) and SP ENW (September 2026 edition) are carried forward from Edition 1.

Earlier posts and articles are archived at markdmoore.co.uk

Embedded Capacity Register tracker, Edition 2, six DNO registers, October collection against 18 September 2026: 2,764 schemes, 112.6 GW accepted to connect, down 1.9 GW net; 4 of 6 registers refreshed.

Embedded Capacity Register tracker: Edition 1

Posted 22 September 2026 · DNO registers collected 18 September 2026

Around 114.5 GW is accepted to connect to Britain’s distribution networks and not yet energised. That’s roughly 2,800 schemes at 1 MW and above, across all six distribution network operators. For scale, the transmission queue on the TEC Register stood at 688.5 GW on the 14 August file. Distribution is running at about a sixth of it. Read the full post

This is edition one of a monthly tracker. It’s a baseline. There’s nothing to measure movement against yet, and edition two in October gives the first comparison.

The counting basis, stated plainly. Accepted to Connect Registered Capacity as published, each operator’s own current file, summed per operator, no cross-register deduplication.

SP Energy Networks needs a note. Its current file runs to 1,501 rows carrying 777 distinct identifiers, with 724 of those appearing twice and the pairs differing from each other on capacity. I’ve read that as one scheme per identifier, which gives 10.9 GW. Summing every row gives 21.3 GW. I haven’t assumed which is intended, so the national figure takes the lower reading. If SPEN reads it differently, I’d be glad to correct it.

Northern Powergrid does publish a combined national file. When I inspected it, the data was six months old and the portal capped retrieval at 10,000 of its 20,075 rows.

So the number exists only if somebody assembles it by hand from six separately formatted files, two of which need an account before they’ll show you anything.

Connections reform is run to targets and reported against transmission. If a sixth of the queue sits at distribution with no current published national total, what is the reform being measured against?

Provenance: Primary. Computed from the six DNO groups’ own published Embedded Capacity Registers, collected 18 September 2026. TEC comparator from the NESO Transmission Entry Capacity Register, file of 14 August 2026. Independent, no client.

Graphic accompanying the post: Embedded Capacity Register tracker: Edition 1
